A key customer faced an urgent production risk when newly supplied change parts for their OEM equipment failed to function as intended.
Fitment issues and performance inconsistencies threatened uptime, putting the production schedule at risk.
With limited time and no room for additional trial-and-error, the customer needed a partner who could quickly assess the real machine conditions, correct the design issues, and deliver validated replacement parts without disrupting the existing system configuration.
This was not a simple part replacement. The situation required:
There was no margin for trial and error. Every step had to work the first time.
Once engaged, Morrison moved from official PO to shipment in 7 business days, including:
The timeline was compressed through parallel execution across departments, eliminating delays between phases and reducing risk at each stage.
When production was on the line, responsiveness was critical.
Within hours of receiving the SOS, Morrison mobilized a cross-functional rapid response team:

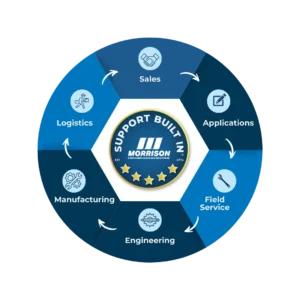

Sales ā Applications ā Field Service ā Engineering ā Manufacturing ā Logistics
Each function executed in parallel to compress time and eliminate risk.
Sales
Confirmed scope, urgency, and customer requirements to activate internal response immediately.
Applications
Evaluated feasibility using existing machine data and past OEM system experience. Prioritized simplified, high-confidence design paths to accelerate execution.
Field Service
Dispatched to the facility to:
Capture 3D scansReal-time photos and data were shared internally to accelerate design validation.
Ā
Engineering

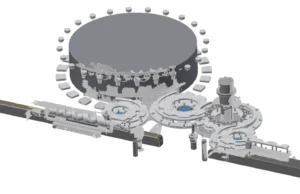

Converted field data into validated designs, incorporating machine-specific tolerances to eliminate interference risk and maintain compatibility with the existing OEM configuration.
Manufacturing
Committed production capacity immediately once designs were validated. Materials were secured without delay.
Logistics
Pre-coordinated international shipment before production was complete, enabling expedited air transport the moment parts cleared manufacturing.

Replacement change parts and components were manufactured using high-performance plastics and fabricated materials matched to the application requirements.
Each part was designed using real machine data captured on-site to prevent interferences and maintain compatibility with the existing OEM system configuration.
Under extreme time pressure, Morrison delivered validated change parts that protected the customerās production schedule.
Parallel execution across departments compressed the timeline from design through shipment while reducing risk at every stage.
On-site measurement eliminated fitment uncertainty, while expedited logistics enabled immediate air transport. As a result, the line stabilized quickly and production resumed within the customerās required window.
Impact
When production was on the line, the response required more than parts.
It required mobilization, coordination, and execution without hesitation.
This rapid response demonstrated Morrisonās ability to design, manufacture, and deliver under pressure ā backed by synchronized teamwork and a customer-first mindset.
"*" indicates required fields
Ā© 2025 Morrison Container Handling SolutionsĀ |Ā Privacy PolicyĀ |Ā Accessibility Statement | Patents
335 West 194th Street | Glenwood, IL 60425 | tel: 708-756-6660 | fax: 708-756-6620
This website was produced and supported by FARM.
